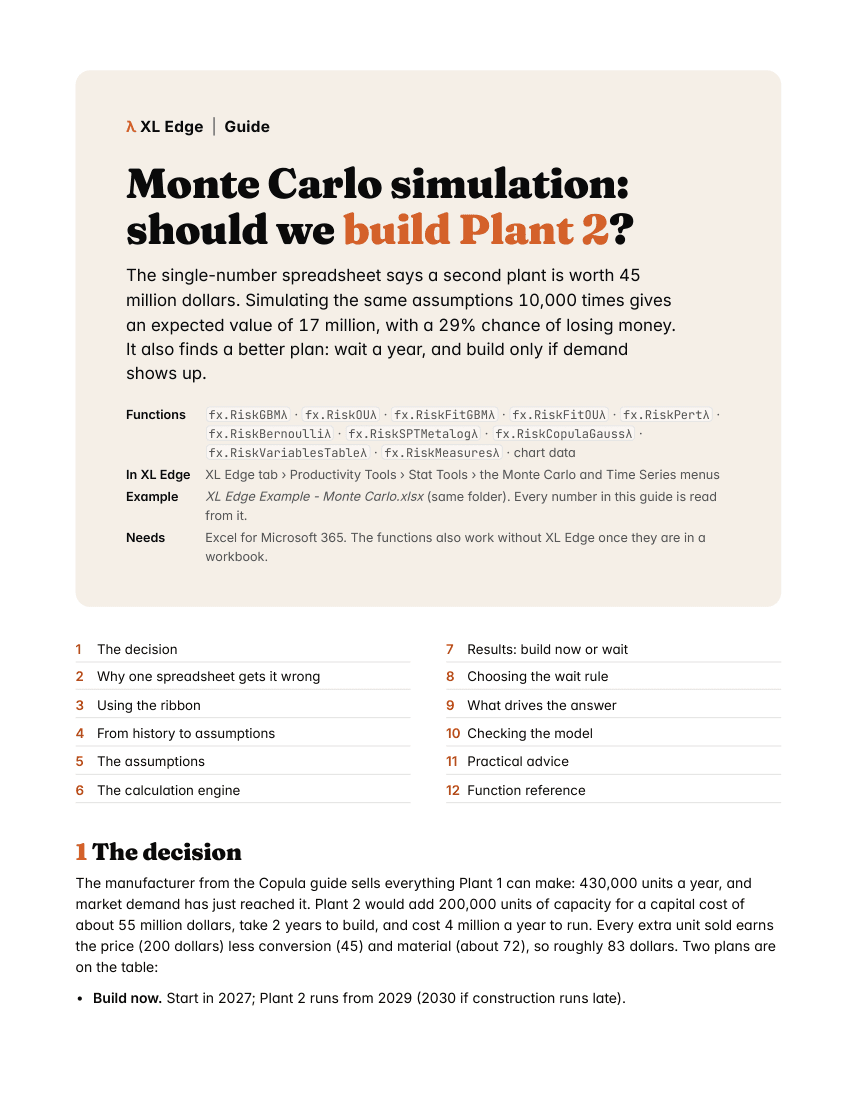

XL Edge Guide · Monte Carlo

Monte Carlo simulation: should we build Plant 2?

The single-number spreadsheet says a second plant is worth 45 million dollars. Simulating the same assumptions 10,000 times gives an expected value of 17 million, with a 29% chance of losing money. It also finds a better plan: wait a year, and build only if demand shows up.

What the guide covers

In this guide

  1. 1The decision
  2. 2Why one spreadsheet gets it wrong
  3. 3Using the ribbon
  4. 4From history to assumptions
  5. 5The assumptions
  6. 6The calculation engine
  7. 7Results: build now or wait
  8. 8Choosing the wait rule
  9. 9What drives the answer
  10. 10Checking the model
  11. 11Practical advice
  12. 12Function reference

What it uses

Functions
fx.RiskGBMλfx.RiskOUλfx.RiskFitGBMλfx.RiskFitOUλfx.RiskPertλfx.RiskBernoulliλfx.RiskSPTMetalogλfx.RiskCopulaGaussλfx.RiskVariablesTableλfx.RiskMeasuresλthe chart data functions
In the ribbon
XL Edge tab › Productivity Tools › Stat Tools › the Monte Carlo and Time Series menus
Example workbook
The same manufacturer as the Copula guide, with simulated demand and material-cost history; every assumption is illustrative. Every number in the guide is read from it.
Needs
Excel for Microsoft 365. The workbook carries its own functions in Name Manager, so it calculates with or without XL Edge installed.
